Week 11 | Session 4: SC Digital Twin - Network Optimization (Excel + AnyLogistix)
Course: Supply Chain Digitization - Module 4: Digital Infrastructure
Session Agenda
Section titled “Session Agenda”1. Context - Moving from GFA to Network Optimization
Section titled “1. Context - Moving from GFA to Network Optimization”GFA (Sessions 2 & 3) found the optimal DC location from scratch - 1 DC, minimize transport cost.
This session: demand has doubled, a new factory is needed, and the existing DC lease is expiring. Must simultaneously decide: which factory to open, which DC to open, and how to route flows.
GFA vs Network Optimization - Comparison
Section titled “GFA vs Network Optimization - Comparison”| Attribute | GFA (Sessions 2 & 3) | Network Optimization (This Session) |
|---|---|---|
| Question answered | WHERE to place a new DC from scratch? | Which factories/DCs to open AND how to route flows? |
| Objective | Minimize transportation cost | Maximize profit (Revenue − all costs) |
| Decision variables | xDC (lat), yDC (long) - 2 variables only | yᵢ (factory open), zⱼ (DC open), xᵢⱼ (flows), qⱼₖ (flows) |
| Facility options | Infinite possible coordinates | Fixed candidate locations - choose which to open |
| Variable type | Continuous - lat/long are real numbers | Mixed Integer - binary (yᵢ, zⱼ) + continuous (xᵢⱼ, qⱼₖ) |
| Solver method | GRG Non-linear (spherical distance is non-linear) | Simplex LP (all linear constraints and objective) |
| Cost components | Distance × demand × transport cost only | Fixed + production + inbound/outbound + transport costs |
2. Case Study - Pharma Company Network Redesign

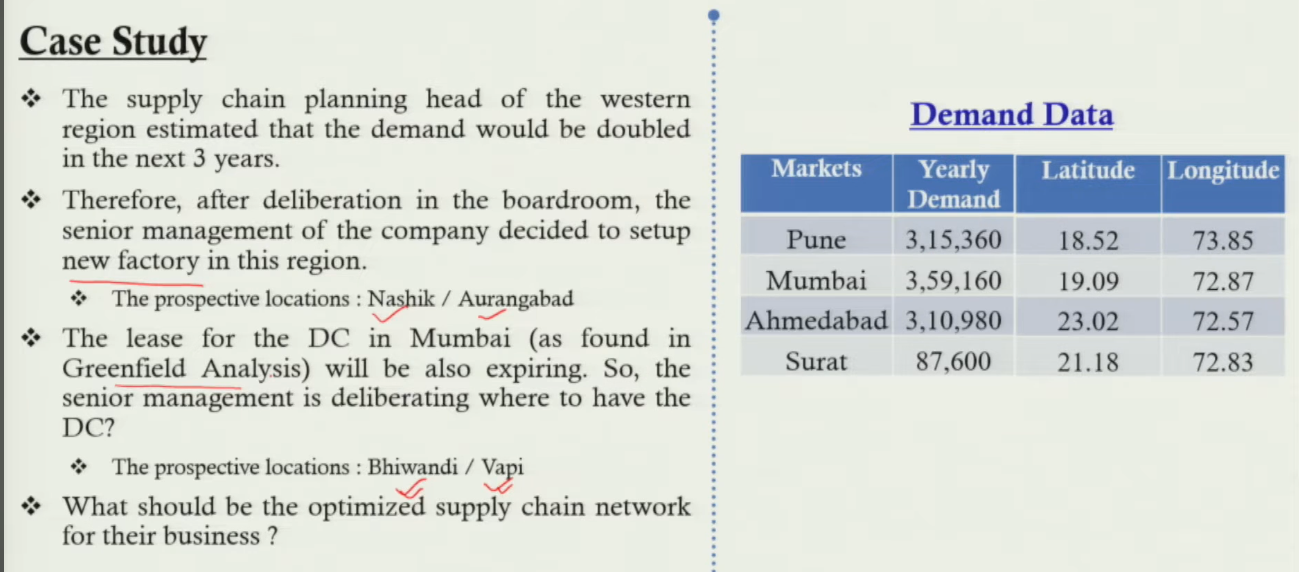

Section titled “2. Case Study - Pharma Company Network Redesign”Demand data - four markets (yearly demand doubled for the 3-year horizon):
| Market | Yearly Demand | Latitude | Longitude |
|---|---|---|---|
| Pune | 3,15,360 | 18.52 | 73.85 |
| Mumbai | 3,59,160 | 19.09 | 72.87 |
| Ahmedabad | 3,10,980 | 23.02 | 72.57 |
| Surat | 87,600 | 21.18 | 72.83 |
Background:
- Demand in western region will double in next 3 years - current capacity insufficient.
- Management decides to set up a new factory at one of: Nashik OR Aurangabad.
- DC in Mumbai (from GFA) lease is expiring - must relocate to one of: VAPI OR V1D (Viwandi).
- Markets remain: Pune, Mumbai, Ahmedabad, Surat - but demand is now doubled.
All Node Data
Section titled “All Node Data”| Node | Location | Prod/Proc Cost/unit | Key Distances |
|---|---|---|---|
| Factory 1 | Nashik | $7/unit production | → VAPI 144 km, → V1D 129 km |
| Factory 2 | Aurangabad | $5/unit production | → VAPI 322 km, → V1D 297 km |
| DC 1 | VAPI | $0.25 inbound/outbound | → Mumbai 169 km, Pune 298 km, Surat 102 km, Ahm 346 km |
| DC 2 | V1D (Viwandi) | $0.50 inbound/outbound | → Mumbai 35 km, Pune 151 km, Surat 254 km, Ahm 487 km |
Transport cost: $0.001/km/unit. Revenue: $15 per unit sold.
Four Decisions to be Made Simultaneously
Section titled “Four Decisions to be Made Simultaneously”- Open factory at Nashik, Aurangabad, or both?
- Open DC at VAPI, V1D, or both?
- Which factory supplies which DC (xᵢⱼ)?
- Which DC serves which market - and how much (qⱼₖ)?

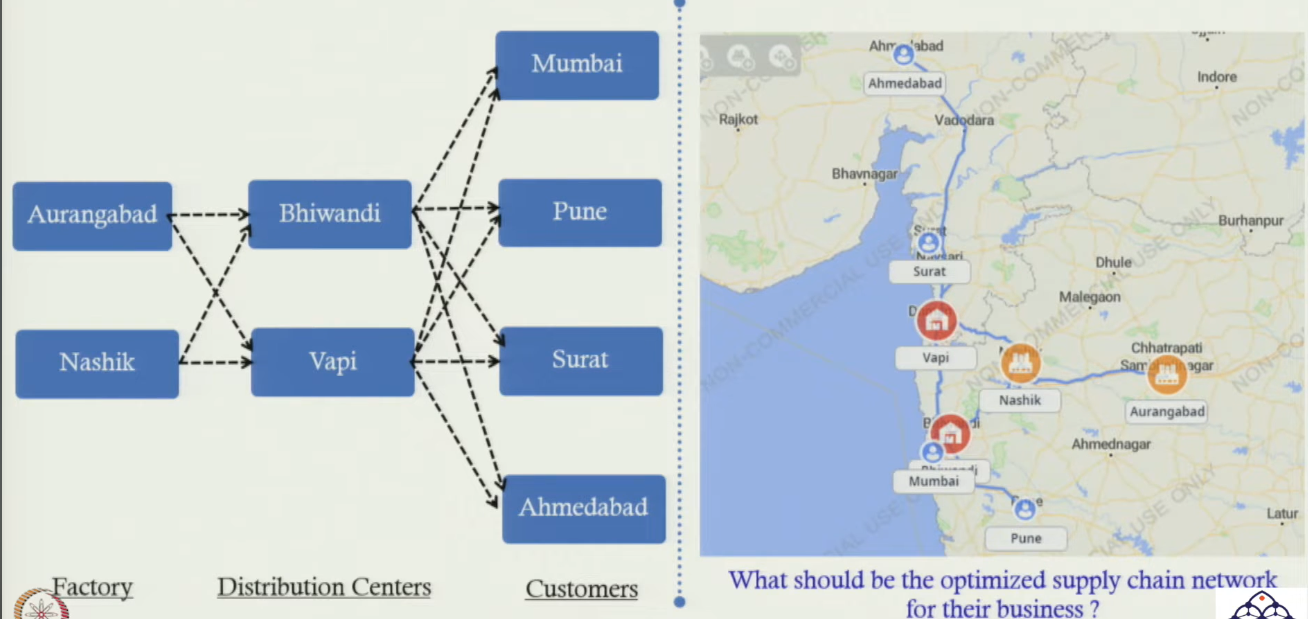

3. Decision Variables
Section titled “3. Decision Variables”Candidate factory data:

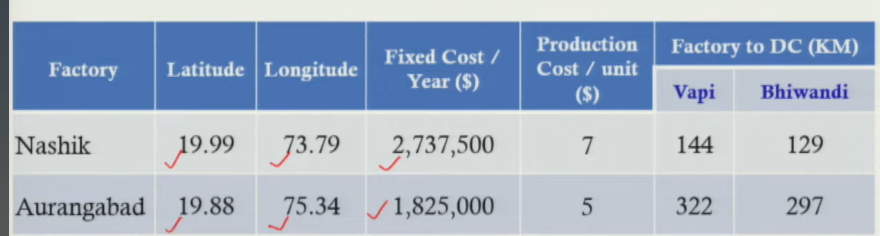

| Factory | Lat | Long | Fixed cost/yr ($) | Prod. cost/unit ($) | → Vapi (km) | → Bhiwandi (km) |
|---|---|---|---|---|---|---|
| Nashik | 19.99 | 73.79 | 2,737,500 | 7 | 144 | 129 |
| Aurangabad | 19.88 | 75.34 | 1,825,000 | 5 | 322 | 297 |
Candidate DC data:

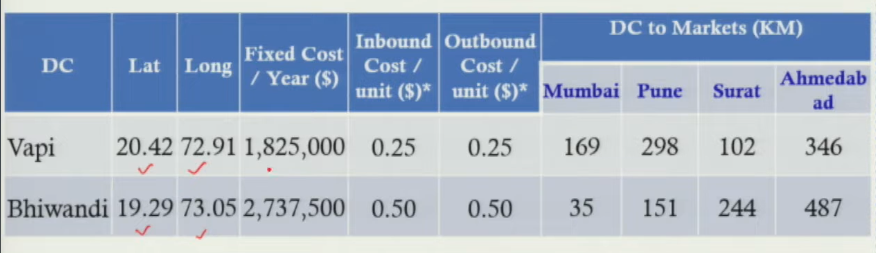

| DC | Lat | Long | Fixed cost/yr ($) | Inbound/unit | Outbound/unit |
|---|---|---|---|---|---|
| Vapi | 20.42 | 72.91 | 1,825,000 | 0.25 | 0.25 |
| Bhiwandi | 19.29 | 73.05 | 2,737,500 | 0.50 | 0.50 |
| DC → market distance (km) | Mumbai | Pune | Surat | Ahmedabad |
|---|---|---|---|---|
| Vapi | 169 | 298 | 102 | 346 |
| Bhiwandi | 35 | 151 | 244 | 487 |
| Variable | Type | Meaning |
|---|---|---|
| yᵢ | Binary 1 | = 1 if ith factory is OPEN; = 0 if NOT open. i = 1 (Nashik), i = 2 (Aurangabad) |
| zⱼ | Binary 1 | = 1 if jth DC is OPEN; = 0 if NOT open. j = 1 (VAPI), j = 2 (V1D) |
| xᵢⱼ | Continuous ≥ 0 | Quantity shipped from ith factory to jth DC |
| qⱼₖ | Continuous ≥ 0 | Quantity shipped from jth DC to kth customer (k = 1..4 markets) |
Big M: a very large number. If a facility is open (y=1 or z=1), capacity = M (unlimited). If closed (=0), capacity = 0 - cannot send or receive anything.

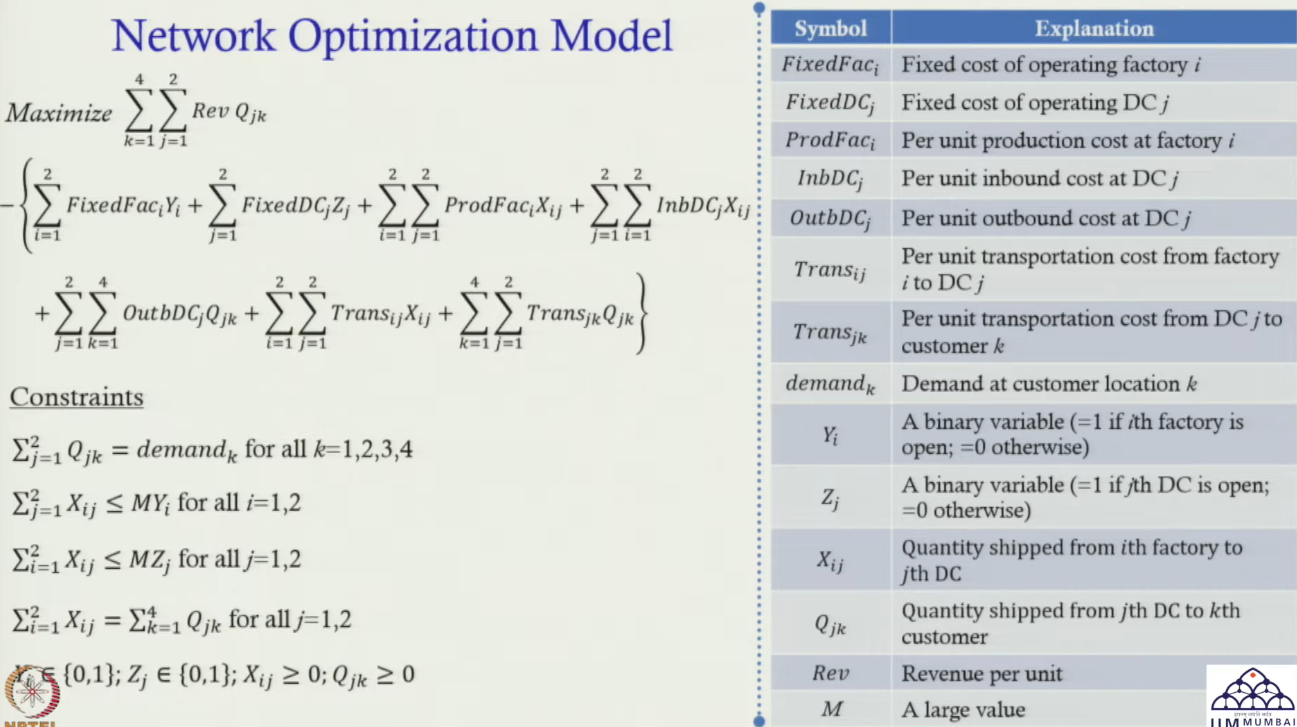

4. Objective Function - Maximize Profit
Section titled “4. Objective Function - Maximize Profit”Maximize Z = Revenue − Factory Fixed Cost − DC Fixed Cost − Production Cost − Inbound Cost − Outbound Cost − Factory→DC Transport Cost − DC→Customer Transport Cost| Cost / Revenue Component | Expression | Explanation |
|---|---|---|
| Revenue | Σⱼ Σₖ (Rev × qⱼₖ) | Rev = $15/unit. Total revenue = units sold × price. |
| Factory Fixed Cost | Σᵢ (FC_factory_i × yᵢ) | If yᵢ = 0: cost = 0 (factory not open). If yᵢ = 1: incur fixed cost. |
| DC Fixed Cost | Σⱼ (FC_dc_j × zⱼ) | If zⱼ = 0: cost = 0 (DC not open). If zⱼ = 1: incur fixed cost. |
| Production Cost | Σᵢ Σⱼ (PC_i × xᵢⱼ) | PC_i = production cost per unit at factory i ($7 Nashik, $5 Aurangabad). |
| Inbound Processing | Σᵢ Σⱼ (IB_j × xᵢⱼ) | IB_j = cost per unit for inbound processing at DC j ($0.25 VAPI, $0.50 V1D). |
| Outbound Processing | Σⱼ Σₖ (OB_j × qⱼₖ) | OB_j = cost per unit for outbound processing at DC j. |
| Factory → DC Transport | Σᵢ Σⱼ (TC × dist_ij × xᵢⱼ) | TC = $0.001/km/unit. dist_ij = km from factory i to DC j. |
| DC → Customer Transport | Σⱼ Σₖ (TC × dist_jk × qⱼₖ) | dist_jk = km from DC j to customer k. |
5. Constraints
Section titled “5. Constraints”| Constraint | Expression | What it Enforces |
|---|---|---|
| Demand satisfaction | Σⱼ qⱼₖ = Dₖ ∀k | Total shipments from all DCs to customer k must equal customer k’s full demand. |
| Factory capacity | Σⱼ xᵢⱼ ≤ M × yᵢ ∀i | If factory i open (yᵢ=1): can ship up to M units. If closed (yᵢ=0): capacity = 0. |
| DC capacity | Σₖ qⱼₖ ≤ M × zⱼ ∀j | If DC j open (zⱼ=1): can process up to M units. If closed (zⱼ=0): cannot process. |
| Flow balance at DC | Σᵢ xᵢⱼ = Σₖ qⱼₖ ∀j | What flows INTO each DC must equal what flows OUT. No inventory held at DC. |
| Binary variables | yᵢ, zⱼ ∈ 1 | Factory open/close and DC open/close are binary decisions. |
| Non-negativity | xᵢⱼ, qⱼₖ ≥ 0 | Flow quantities cannot be negative. |
6. Excel Solver - Setup & Results
Section titled “6. Excel Solver - Setup & Results”max Σ Rev·Qjk − [ Σ FixedFaci·Yi + Σ FixedDCj·Zj + Σ ProdFaci·Xij + Σ InbDCj·Xij + Σ OutbDCj·Qjk + Σ Transij·Xij + Σ Transjk·Qjk ]Σj Qjk = demandk · Σj Xij ≤ M·Yi · Σi Xij ≤ M·Zj
Σi Xij = Σk Qjk (flow balance) · Yi, Zj ∈ 1 · Xij, Qjk ≥ 0| Solver Setting | Value / Detail |
|---|---|
| Set Objective | Total Profit cell (Revenue − Cost) |
| To | Max (Maximize) |
| Changing Variables | yᵢ (factory binary), zⱼ (DC binary), xᵢⱼ (factory→DC flows), qⱼₖ (DC→customer flows) |
| Constraint 1 | DC inflow ≤ DC capacity (= M×zⱼ) |
| Constraint 2 | Demand satisfaction at all 4 markets |
| Constraint 3 | Factory outflow ≤ factory capacity (= M×yᵢ) |
| Constraint 4 | Flow balance: DC inflow = DC outflow |
| Binary constraint | yᵢ and zⱼ set as binary (0 or 1 only) |
| Method | Simplex LP - objective and all constraints are linear |
| Result | Aurangabad factory: OPEN. VAPI DC: OPEN. Nashik + V1D: CLOSED. Profit = ₹59,27,495 |
Why Simplex LP (not GRG Non-linear)?
Section titled “Why Simplex LP (not GRG Non-linear)?”Distances are given as fixed inputs (km values) - not calculated via spherical formula. Objective function and all constraints are linear in the decision variables. Binary variables are handled as integer constraints - Simplex LP handles this as Mixed Integer LP.
7. Optimal Solution - Results
Section titled “7. Optimal Solution - Results”Facilities to Open:
- Factory: Aurangabad - OPEN (lower production cost $5/unit vs Nashik $7/unit)
- DC: VAPI - OPEN (lower inbound/outbound cost $0.25 vs V1D $0.50)
- Nashik factory: CLOSED. V1D (Viwandi) DC: CLOSED.
Product Flow:
- Aurangabad factory → VAPI DC → all 4 markets
- VAPI DC → Mumbai: 3,59,160 units
- VAPI DC → Pune: 3,15,360 units
- VAPI DC → Surat & Ahmedabad: demand matched exactly.
Optimal Profit: ₹59,27,495 - identical from Excel Solver and AnyLogistix.
8. AnyLogistix - Network Optimization Module
Section titled “8. AnyLogistix - Network Optimization Module”When 4 SKUs are added + daily demand → number of decision variables multiplies. Excel cannot handle large Mixed Integer Programs (MIP) efficiently. AnyLogistix has built-in MIP solver + map visualization + route details + flow breakdown.
Data Entry in AnyLogistix - Network Optimization Module
Section titled “Data Entry in AnyLogistix - Network Optimization Module”- Customers: Pune, Mumbai, Ahmedabad, Surat - 4 markets.
- Facilities: Aurangabad (factory), Nashik (factory), VAPI (DC), V1D (DC).
- Demand: per day per SKU (4 SKUs × 4 markets = 16 demand entries).
- Revenue: $15 per unit. Facility expenses: fixed cost per day.
- Objective: Revenue − Fixed cost − Inbound − Outbound − Production − Transport.
- Run → solution in seconds - same result as Excel: Aurangabad + VAPI, profit = ₹59,27,495.
Additional Outputs from AnyLogistix
Section titled “Additional Outputs from AnyLogistix”- Map visualization: actual road routes from Aurangabad → VAPI → customers.
- Flow details: Aurangabad → VAPI: SKU1 = 3,13,900 units, distance shown, transport cost shown.
- Per-route breakdown: every factory→DC and DC→customer flow with units, km, cost.
- Multiple cost layers: processing cost, flow cost, transport cost shown separately per arc.
Session Summary
Section titled “Session Summary”- Context: demand doubled → need new factory + DC. Candidates: Nashik/Aurangabad (factory), VAPI/V1D (DC).
- 4 decisions: which factories to open (yᵢ), which DCs to open (zⱼ), factory→DC flows (xᵢⱼ), DC→customer flows (qⱼₖ).
- Objective: Maximize Profit = Revenue − all 7 cost components (fixed + variable + transport).
- Big M trick: if facility closed (0) → capacity = 0 → cannot send/receive. Open (1) → capacity = M (unlimited).
- Flow balance: inflow to DC = outflow from DC. DCs are pass-through - no inventory held.
- Solver: Simplex LP (linear model, binary integer constraints). Contrast with GFA which used GRG Non-linear.
- Result: Aurangabad factory + VAPI DC. Profit = ₹59,27,495. Identical from Excel and AnyLogistix.
