Week 3 | Session 4: Kraljic Matrix - Quadrant Strategies & Applications
Course: Supply Chain Digitization
Quick Recap - Session 3
Section titled “Quick Recap - Session 3”Two Ways to Use the Kraljic Matrix
Section titled “Two Ways to Use the Kraljic Matrix”1. Starting Fresh - New Business or New Procurement Setup
Section titled “1. Starting Fresh - New Business or New Procurement Setup”- No history of procurement yet
- Use the matrix to anticipate potential profit impact and supply risk
- Build a proactive strategy before issues arise
2. Reviewing Existing Strategy - Established Organisation
Section titled “2. Reviewing Existing Strategy - Established Organisation”- Organisation has been operating 10-15 years and faces procurement problems - missed orders, supplier failures, cost overruns, or procured items no longer fitting well and impacting downstream client relationships
- Categorise all currently procured items into the four Kraljic quadrants
- Identify what targeted interventions are needed per category
- Execute the strategy changes - supplier development, substitutions, renegotiations, or decentralisation

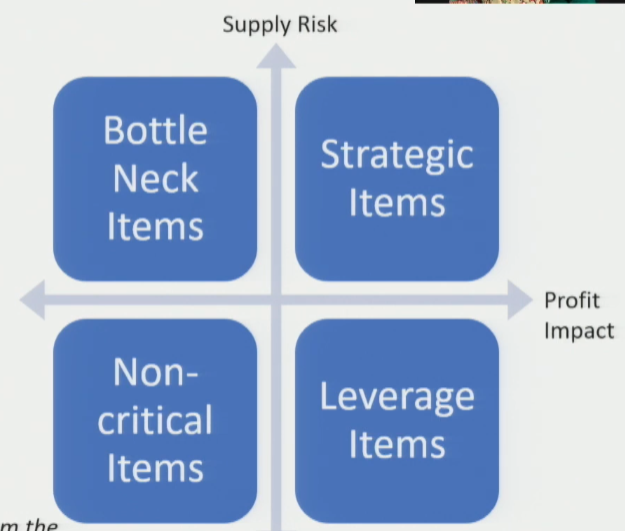

Reading the Kraljic Matrix - Axis Interpretation
Section titled “Reading the Kraljic Matrix - Axis Interpretation”- High supply risk · low profit impact
- High supply risk · high profit impact
- Low supply risk · low profit impact
- Low supply risk · high profit impact
X-Axis: Profit Impact →
Section titled “X-Axis: Profit Impact →”| Position | Meaning | Measurement Tools |
|---|---|---|
| Right (High) | Items contributing a large percentage of total purchase value (30-40%) - expensive, high-spend items | Spend analysis, ABC analysis, VED analysis |
| Left (Low) | Cheaper items representing a smaller share of total purchase spend | Same tools applied at lower thresholds |
Y-Axis: Supply Risk ↑
Section titled “Y-Axis: Supply Risk ↑”| Position | Meaning | Example |
|---|---|---|
| Top (High risk) | Few suppliers, distant suppliers, perishable items, or highly unique specifications | An item with only 1 global supplier → very high risk |
| Bottom (Low risk) | Many suppliers, local availability, easy substitutability | An item with 1,000 available suppliers → very low risk |
The Four Quadrants - Characteristics & Strategies
Section titled “The Four Quadrants - Characteristics & Strategies”Non-Critical - Low Risk + Low Cost
Section titled “Non-Critical - Low Risk + Low Cost”| Attribute | Detail |
|---|---|
| Supply risk | Low - many suppliers, easy substitutability |
| Profit impact | Low - cheap items, small share of spend |
| Nature | Standardised, highly available |
| Challenge | Appears ideal but is rare in practice - monopolies can temporarily create this state, but competitors enter and suppliers split across clients, so risk rises again |
Strategy: Automate and decentralise purchasing. Spot purchases from local market are acceptable - prices are well-defined and competition among suppliers limits price volatility.
Bottleneck - High Risk + Low Cost
Section titled “Bottleneck - High Risk + Low Cost”| Attribute | Detail |
|---|---|
| Supply risk | High - few suppliers, distant, unique specifications, or perishable |
| Profit impact | Low - the item itself is not expensive |
| Core threat | Supply disruption - even though the item is cheap, its unavailability can halt production |
| Buyer position | Weak - limited alternatives |
Strategy: Secure supply continuity through buffer stock, alternative supplier development, or substitute identification.
Leverage - Low Risk + High Cost
Section titled “Leverage - Low Risk + High Cost”| Attribute | Detail |
|---|---|
| Supply risk | Low - many supplier options exist in the market |
| Profit impact | High - expensive items representing a significant share of spend |
| Buyer position | Strong - multiple suppliers competing for the business gives the buyer negotiating power |
Strategy: Actively exploit purchasing power through competitive bidding, volume optimisation, and price negotiation.
Strategic - High Risk + High Cost
Section titled “Strategic - High Risk + High Cost”| Attribute | Detail |
|---|---|
| Supply risk | High - few or single global suppliers, unique or rare inputs |
| Profit impact | High - major share of total spend |
| Buyer position | Weak - supplier dominates the relationship |
| Supplier’s leverage | ”I have the product, your competitors want it too - take it at my price or I go elsewhere” |
Strategy: Long-term supplier relationships, joint ventures, or supplier acquisition. Cost reduction through negotiation alone is largely ineffective here.
Strategic Interventions - Reducing Supply Risk
Section titled “Strategic Interventions - Reducing Supply Risk”Goal: Move Bottleneck and Strategic items towards lower-risk quadrants.
Option 1 - Add More Suppliers
Section titled “Option 1 - Add More Suppliers”Identify and formally qualify alternative suppliers to reduce dependence on any single source. More supplier options = lower supply risk per item.
Option 2 - Joint Venture or Supplier Takeover
Section titled “Option 2 - Joint Venture or Supplier Takeover”When to use: Only one supplier exists globally, the item is rare, and procurement volumes are high enough to justify the investment.
- A long-term Joint Venture (JV) or acquisition of the supplier permanently secures supply
- Removes supplier dominance - the buyer becomes a co-owner or owner of the supply source
- The most structurally permanent form of supply risk reduction
Option 3 - Carry Safety Stock (Buffer Inventory)
Section titled “Option 3 - Carry Safety Stock (Buffer Inventory)”Why: High supply risk → late deliveries are likely → pre-purchase excess inventory to buffer against demand shocks and supply delays.
Option 4 - Find Substitutes
Section titled “Option 4 - Find Substitutes”Logic: High supply risk often stems from unique specifications - a specific chemical composition, shape, or size. If a substitute can deliver the same functional output, supply risk is distributed across more items and more suppliers.
Strategic Interventions - Reducing Cost
Section titled “Strategic Interventions - Reducing Cost”Goal: Reduce cost for Leverage and Strategic items (the high profit impact side of the matrix).
For Strategic Items - Cost Reduction is Structurally Difficult
Section titled “For Strategic Items - Cost Reduction is Structurally Difficult”The supplier is the dominating party - buyer negotiating power is limited.
For Leverage Items - Buyer Has Full Negotiating Power
Section titled “For Leverage Items - Buyer Has Full Negotiating Power”Many suppliers in the market → the buyer is the dominating party. Three cost reduction tactics apply:
| Tactic | Mechanism |
|---|---|
| Enable supplier competition | Invite competitive bids and tenders → drives prices down through market competition |
| Optimise order quantity | Consolidate volumes to qualify for volume discounts |
| Find substitutes | If cost cannot be reduced through negotiation → identify a substitute item and exit the current supplier relationship |
Streamlining Procurement Transactions
Section titled “Streamlining Procurement Transactions”Beyond risk and cost - look at how procurement is executed operationally.
E-Procurement and Automation
Section titled “E-Procurement and Automation”- Electronic procurement portals reduce the cost of searching for and connecting with suppliers
- Significant growth in e-procurement adoption across industries
- Automates routine transactions, freeing procurement teams for strategic work
Decentralisation of Purchase Decisions
Section titled “Decentralisation of Purchase Decisions”Since non-critical items carry low value and low risk, they do not require central strategic oversight.
Action: Delegate procurement authority to the relevant facility, division, or local procurement committee.
Allow: Spot purchases directly from the local market based on operational need.
Direction of Movement - Ideal Strategy Goals
Section titled “Direction of Movement - Ideal Strategy Goals”The ultimate goal for every item in the supply portfolio is to move it towards the Non-Critical quadrant - low risk, low cost.
| Current Quadrant | Target Direction | Primary Interventions |
|---|---|---|
| Bottleneck | → Non-Critical | Reduce supply risk: add suppliers, carry stock, find substitutes |
| Strategic | → Leverage, then Non-Critical | Reduce risk first (JV/takeover), then reduce cost (competitive bidding) |
| Leverage | → Non-Critical | Reduce cost: competitive bidding, volume optimisation, substitutes |
| Non-Critical | Maintain | Automate and decentralise purchasing |
Session Summary
Section titled “Session Summary”| Topic | Key Points |
|---|---|
| Two uses of Kraljic | Proactive (new business) | Corrective (existing organisation) - always segment first, then strategise |
| Risk reduction tools | Add suppliers | JV / Takeover | Carry safety stock | Find substitutes |
| Cost reduction tools | Competitive bidding (Leverage) | JV / Takeover (Strategic) | Substitutes | Optimal order quantity |
| Streamlining tools | E-procurement automation | Decentralised spot purchasing (Non-Critical) |
| Direction of movement | All quadrants → Non-Critical (ideal but rarely fully achievable) |
