Week 2 | Session 3: Product Segmentation, SC Strategy Matching & Push-Pull Framework

Course: Supply Chain Digitization

Central Question - What is the Right SC for a Given Product?

Section titled “Central Question - What is the Right SC for a Given Product?”

Two inputs must be understood before the SC strategy can be determined:

  1. The type and nature of the product flowing through the SC
  2. The priority / competitive strategy of the SC

Together, these determine whether the SC should be Efficient or Responsive, and whether it should operate on a Push or Pull basis.

Product Segmentation - Functional vs. Innovative

Section titled “Product Segmentation - Functional vs. Innovative”
Efficient SC → Push
  • Demand: Stable, constant, low uncertainty
  • Product Life Cycle: Long
  • Lead Time: Longer - focus is on consolidation, coordination, and cost
  • Average Stockout Rate: Low - sufficient inventory always maintained
  • Product Variety: Low - same products used repeatedly, minimal variation
  • SC Focus: Cost minimisation

Responsive SC → Pull
  • Demand: Volatile, uncertain, unpredictable
  • Product Life Cycle: Short - driven by new technology, new materials, and quality improvements
  • Lead Time: Short - product must be available as soon as demand arises
  • Average Stockout Rate: High - high demand uncertainty = higher stockout risk
  • Product Variety: High - companies must offer more variety to remain competitive
  • SC Focus: Flexibility and responsiveness

DimensionFunctional ProductInnovative Product
DemandStableVolatile / Uncertain
Life CycleLongShort
Lead TimeLongShort
Stockout RiskLowHigh
Product VarietyLowHigh
SC FocusCostFlexibility / Responsiveness
SC TypeEfficientResponsive
StrategyPushPull

ParameterDetail
Demand natureStable → no need for high flexibility
Production strategyForecast-driven
Lead timeLong - acceptable because demand is predictable
Inventory levelLow
GoalMake product available at minimum cost
SC typeEfficient Supply Chain
StrategyPUSH
ParameterDetail
Demand natureVolatile → requires high flexibility
Production strategyDemand-driven (not forecast-driven)
Lead timeShort - customer expects immediate availability
Inventory levelHigh
GoalFulfil demand on a timely basis; manage uncertainty
SC typeResponsive Supply Chain
StrategyPULL

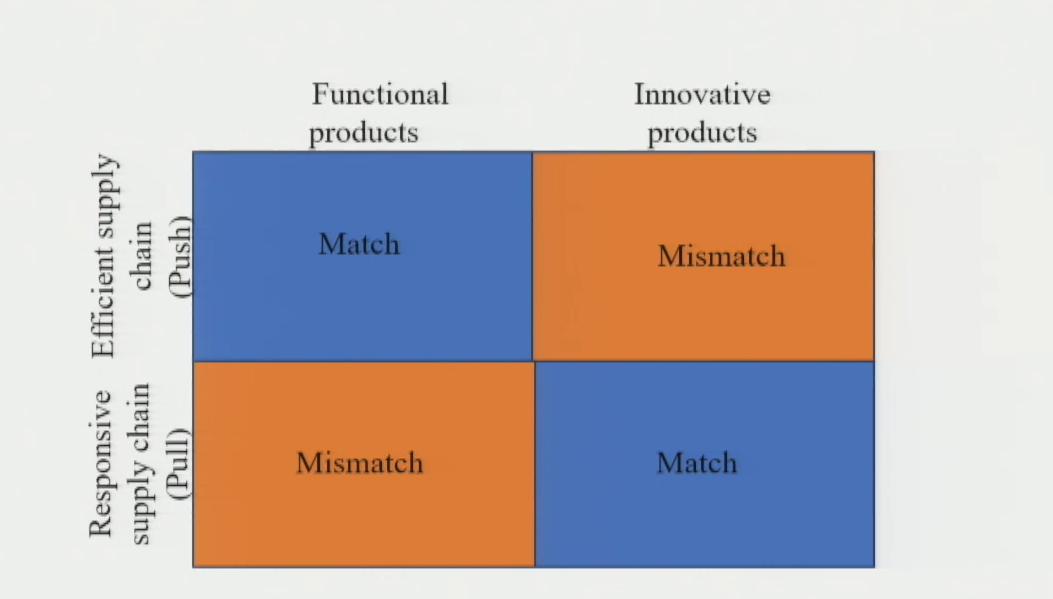

SC type ↓ / Product →Functional productsInnovative products
Efficient SC (Push)MatchMismatch
Responsive SC (Pull)MismatchMatch
Match the product to the supply chain: functional products fit an efficient/push chain, innovative products fit a responsive/pull chain. The off-diagonal combinations are structural mismatches.

Forecast-Driven
CharacteristicDetail
Forecast-drivenAll decisions based on predicted demand
High volume / Mass productionEconomies of scale are the goal
Inventory accumulationStock is built up in anticipation of demand
Low customisationStandard products only
High initial investmentProduction infrastructure sized for volume
  • Limited scope to handle demand variability
  • If products are not sold → carried for long periods → inventory obsolescence risk
  • Low responsiveness to sudden, unanticipated demand changes
  • Demand is stable and predictable
  • Product is functional with a long life cycle
  • The primary goal is cost efficiency

Demand-Driven
CharacteristicDetail
Demand-drivenAll decisions triggered by actual orders
High customisationResponds to specific customer needs
Reduced inventoryNo excess stock built in anticipation
High responsivenessReacts quickly to actual demand signals
Low obsolescence riskNothing produced without confirmed demand
Efficient resource utilisationCapacity is used only when required
  • Lead time management - critical and difficult; customers may have low tolerance for wait time
  • Coordination complexity across partners
  • Demand remains uncertain, making capacity planning harder
  • Production availability constraints - capacity may limit responsiveness
  • Demand is uncertain or volatile
  • Product is innovative with a short life cycle
  • The primary goal is flexibility and responsiveness

Real-World Standard

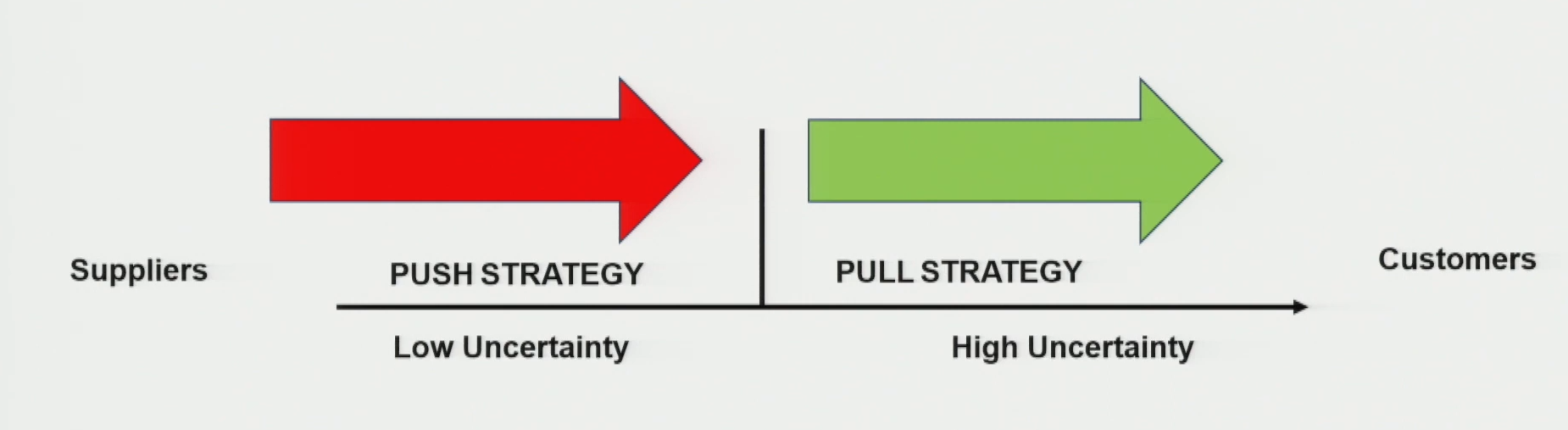

Suppliers
→
Push zoneforecast-driven · low uncertainty
Push-Pull
boundary
Pull zonedemand-driven · high uncertainty
→
Customers
Most real supply chains are hybrids: an upstream push zone (built to forecast) and a downstream pull zone (triggered by real demand), separated by the push-pull boundary.

Push-Pull Example 1 - Vehicle Colour Customisation

Section titled “Push-Pull Example 1 - Vehicle Colour Customisation”
Boundary at Distributor

Setup: A company offers the same vehicle type in different colours and accessories depending on customer choice.

Push Zone - Supplier → Manufacturer → Distributor

Section titled “Push Zone - Supplier → Manufacturer → Distributor”
  • Vehicle type is standard and constant across all orders
  • Suppliers: know exactly which components are needed → keep raw materials ready based on forecast
  • Manufacturing: demand is forecasted → assembly line runs on push strategy
  • Distributor: receives the standard vehicle → holds it in one base configuration

The customer communicates their preferences - colour, seat type, accessories - to the distributor. This order triggers the switch to pull strategy.

  • Distributor customises the vehicle per customer demand (paint, add-on components)
  • Delivery is made after customisation is complete
  • No customisation occurs upstream - only at the distributor level

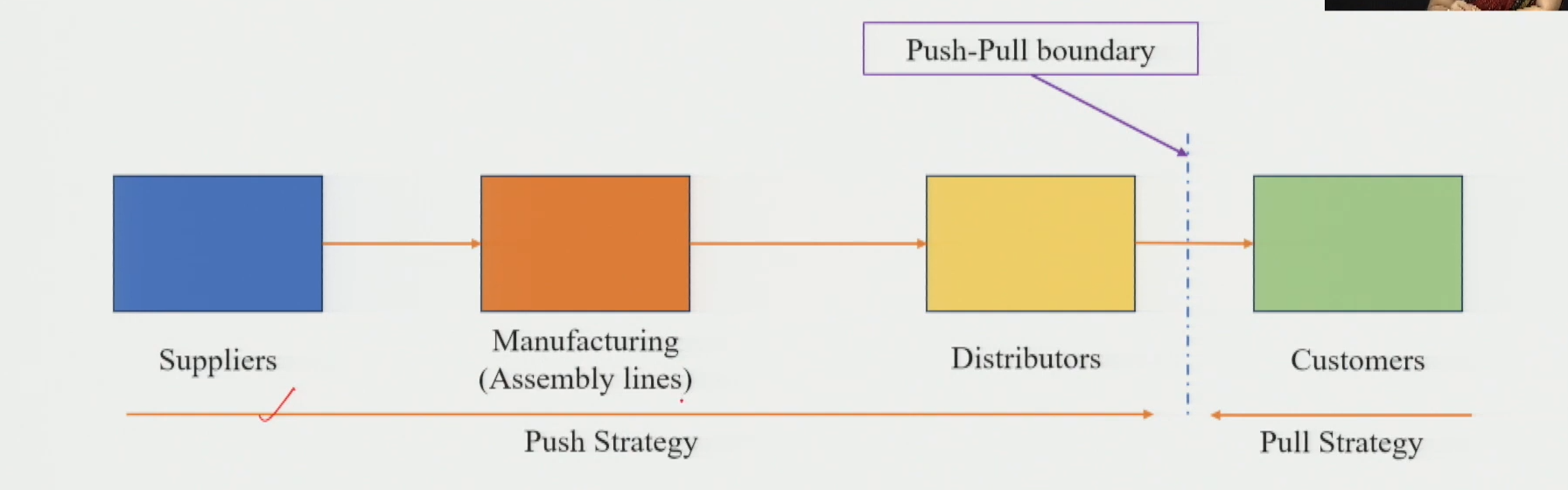

Suppliers
→
Manufacturingassembly lines
→
Distributors
Push-Pull
boundary
Customers
Push - standard vehicle, forecast-driven (Suppliers → Distributor)Pull - colour & accessory customisation (Distributor → Customer)
Example 1 - standardise upstream with push, then customise downstream with pull. The boundary sits at the distributor: the last player before the customer’s specific choices enter the chain.

Push-Pull Example 2 - Component-Level Customisation (Automobiles)

Section titled “Push-Pull Example 2 - Component-Level Customisation (Automobiles)”
Boundary between Supplier & Manufacturer

Setup: An automobile company offers different vehicle variants customised per customer order. Customisation here is at the component and raw material level - not just cosmetic.

  • Suppliers must deliver specific components as per each customer order
  • Suppliers operate on a pull strategy - they produce or deliver only what is explicitly required

Push-Pull Boundary - Between Supplier and Manufacturer

Section titled “Push-Pull Boundary - Between Supplier and Manufacturer”

The boundary sits further upstream here because the variability enters the chain at the component level.

Push Zone - Manufacturing → Distributor → Customer

Section titled “Push Zone - Manufacturing → Distributor → Customer”
  • Once the specified components are received, the assembly process is standard
  • Manufacturing knows exactly how to assemble → follows a push strategy
  • Distributor receives the finished vehicle → standard delivery schedule → pushes to the customer
  • No special requirements at the distributor or delivery stage

Suppliers
Push-Pull
boundary
Manufacturingassembly lines
→
Distributors
→
Customers
Pull - suppliers deliver components per order (Suppliers)Push - standard assembly & delivery (Manufacturing → Customer)
Example 2 - when customisation happens at the component level, the pull zone extends all the way back to suppliers; once assembly is standard, the chain reverts to push. The boundary sits between supplier and manufacturing.

Carry buffer inventory at the players on either side of the boundary. The buffer absorbs demand fluctuations and enables downstream customisation without disrupting upstream forecast-driven operations.

Session Summary - The Full Strategic Chain

Section titled “Session Summary - The Full Strategic Chain”
  1. Product Segmentation → Functional vs. Innovative
  2. SC Type Matching → Functional → Efficient SC | Innovative → Responsive SC
  3. Strategy Matching → Efficient SC → Push | Responsive SC → Pull
  4. Reality → Hybrid Push-Pull separated by a Push-Pull Boundary
  5. Boundary Position → determined by where customisation / uncertainty begins in the SC
  6. Boundary Management → Buffer inventory + Postponement strategy
