Week 9 | Session 5: DEA - Linearization, Excel Solver & Interpretation of Results
Course: Supply Chain Digitization - Module 3: Analytics in SCM
Session Agenda
Section titled “Session Agenda”1. Recap - Session 4
Section titled “1. Recap - Session 4”- DEA model formulated: Maximize weighted output ÷ weighted input for each facility, subject to all facilities’ efficiency ≤ 1.
- Problem: The model is non-linear - decision variables appear in both numerator and denominator.
- This session: Linearize the model, solve in Excel Solver, and interpret results.
2. Converting Non-linear DEA to Linear Programming
Section titled “2. Converting Non-linear DEA to Linear Programming”Nine facilities - two outputs (higher = better) and two inputs (lower = better):
| Facility | Production Yield (%) | OEE (%) | Cycle Time (min) | Resource Utilisation (%) |
|---|---|---|---|---|
| 1 | 92 | 80 | 32 | 88 |
| 2 | 88 | 78 | 35 | 94 |
| 3 | 92 | 81 | 31 | 95 |
| 4 | 90 | 78 | 30 | 82 |
| 5 | 90 | 82 | 34 | 90 |
| 6 | 82 | 76 | 36 | 89 |
| 7 | 96 | 85 | 31 | 91 |
| 8 | 74 | 68 | 35 | 94 |
| 9 | 78 | 76 | 30 | 89 |
Objective (for facility 1, after linearisation)
max 92·v1 + 80·v2Constraints
32·u1 + 88·u2 = 1 (input weights normalised)
∀ facility: (yield·v1 + OEE·v2) − (cycle·u1 + util·u2) ≤ 0Why non-linear? Both numerator (V1·Y1 + V2·Y2) and denominator (U1·X1 + U2·X2) contain decision variables → Y/X type = non-linear.
Strategy: Apply two separate transformations.
| Transformation | Why it works |
|---|---|
1. Constraint (Non-linear to Linear):(V·Y) / (U·X) ≤ 1 → V·Y − U·X ≤ 0 | Cross-multiply denominator to right side. Denominator is positive, so inequality direction stays. |
| 2. Objective (Non-linear to Linear): Maximize (V·Y) / (U·X)Add constraint: U·X = 1→ Linear objective: Maximize V·Y | Fix denominator = 1 via an extra equality constraint. Objective reduces to maximizing numerator alone. |
3. Linearized DEA Model - Facility 1 (Worked Example)

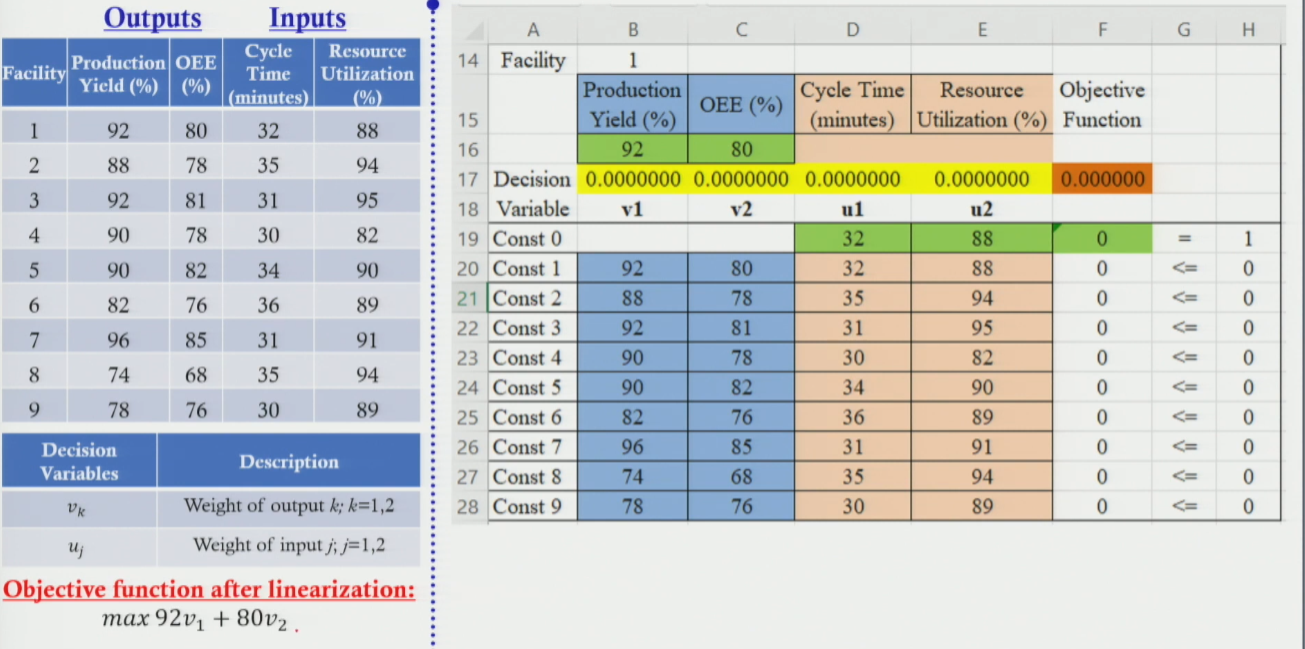

Section titled “3. Linearized DEA Model - Facility 1 (Worked Example)”- Objective Function (linear): Maximize
92·V1 + 80·V2 - Constraint 0 (Denominator = 1):
32·U1 + 88·U2 = 1(changes per facility) - Constraints 1-9 (Efficiency ≤ 1): (linear, fixed for all runs)
- F1:
92·V1 + 80·V2 − 32·U1 − 88·U2 ≤ 0 - F2:
88·V1 + 78·V2 − 35·U1 − 94·U2 ≤ 0 - … (repeat for F3 through F9)
- F1:
Decision Variables & Non-negativity
Section titled “Decision Variables & Non-negativity”V1, V2, U1, U2 ≥ ε (use ε = 0.000001 - never exactly 0 to avoid zero weights).
4. Generalized DEA Model (m inputs, s outputs, n facilities)
Section titled “4. Generalized DEA Model (m inputs, s outputs, n facilities)”| Component | Expression (linearized, for facility p) | Notes |
|---|---|---|
| Objective (changes per run) | Maximize: Σ(k=1 to s) Vk · Ykp | Weighted sum of outputs. |
| Add. Constraint (changes per run) | Σ(j=1 to m) Uj · Xjp = 1 | Fixes denominator = 1. Only inputs of facility p. |
| Efficiency Constraints (same for all) | For each i = 1 to n: Σ Vk·Yki − Σ Uj·Xji ≤ 0 | Ensures no facility’s efficiency > 1. |
| Non-negativity | Vk ≥ ε > 0, Uj ≥ ε > 0 | Use ε = 0.000001 (not 0) to keep parameters relevant. |
5. Excel Solver - Setup & Steps
Section titled “5. Excel Solver - Setup & Steps”- Enter data: Put data + decision variable cells. Use VLOOKUP to auto-fill coefficients.
- Set objective cell: E.g.,
92·V1 + 80·V2(Maximize). - Changing variable cells: Select
V1, V2, U1, U2cells. - Add Constraint 0:
32·U1 + 88·U2 = 1. - Add Constraints 1-9: All 9 facilities’ constraints
≤ 0. - Solve: Use Simplex LP, lower bounds =
ε. Record results and repeat 9 times.
6. Efficiency Results - All 9 Facilities
Section titled “6. Efficiency Results - All 9 Facilities”| Fac. | Efficiency | Gap | Highest Weight Parameter | Status |
|---|---|---|---|---|
| F4 | 100% | 0% | - | Efficient ★ |
| F7 | 100% | 0% | - | Efficient ★ |
| F1 | 95.72% | 4.28% | OEE (V2 highest) | Not efficient |
| F9 | 92.00% | 8.00% | Cycle Time (U1 = 0.033) | Not efficient |
| F2 | 87.00% | 13.00% | OEE & Resource Util | Not efficient |
| F8 | 76.00% | 24.00% | OEE (V2 = 0.011) | Not efficient |
(F4 and F7 serve as benchmarks on the efficient frontier. F8 is the least efficient).
7. How to Interpret DEA Results - Weight-Based Focus
Section titled “7. How to Interpret DEA Results - Weight-Based Focus”The parameter with the highest weight is where efficiency is most sensitive. Focus improvement effort there.
| Scenario | Meaning | Action |
|---|---|---|
| Efficiency = 100% | Facility is on the efficient frontier | No improvement needed - benchmark |
| Output weight (Vk) highest | That output is most sensitive | Increase that output value |
| Input weight (Uj) highest | That input is dragging efficiency down | Reduce that input value |
| Multiple high weights | Both output and input contribute | Improve both simultaneously |
Session Summary
Section titled “Session Summary”- Non-linear → LP: Cross-multiply constraint denominators; add denominator = 1 constraint for objective.
- Solver: Simplex LP, 9 runs.
ε > 0for lower bounds. - Results: F4 and F7 (100%) are efficient. F8 (76%) is least efficient.
- Interpretation: Highest weight parameter = priority improvement area.
