Week 6 | Session 4: Building a Classification Tree - Gini Index, Splitting & Stopping
Course: Supply Chain Digitization - Module 3: Analytics in SCM
Session Agenda
Section titled “Session Agenda”Recap - Session 3 vs. Session 4
Section titled “Recap - Session 3 vs. Session 4”- Session 3: Showed the OUTPUT of the classification tree - 4 leaf node rules, predictions, how to use on shop floor
- Session 4: Explains HOW the tree was built - the algorithm behind it
- Core algorithm logic: Repeatedly split nodes by choosing the variable and cutoff that maximally reduces impurity → until a stopping criterion is met
Step 1 - Start with Root Node (Node 0)
Section titled “Step 1 - Start with Root Node (Node 0)”- Training data: 700 instances (note: model uses 700, full dataset has 1000 - 700 used for training)
- At root (no feature information): 447 machines failed (Yes) | 253 did not fail (No)
- Baseline probability: 447/700 = 64% chance any randomly picked machine will fail
- Problem with baseline: 64% regardless of age, utilisation, oil contamination etc. - ignores all useful information
- Goal of the tree: Incorporate features to improve accuracy beyond the 64% baseline
- Gini at Node 0: 1 − (0.64² + 0.36²) = 1 − (0.41 + 0.13) = 0.46 (close to maximum of 0.5 → highly impure data → room to improve)
Impurity Measures - Gini Index & Entropy
Section titled “Impurity Measures - Gini Index & Entropy”= 1 − Σi=1..k [ P(classi | t) ]²= − Σi=1..k P(classi | t) × log₂ P(classi | t)Why Impurity? Impurity = randomness in a node. A pure node = all observations belong to one class → perfect prediction. The lower the impurity at each leaf node, the higher the accuracy of classification. Goal at every split: choose the variable + cutoff that reduces impurity the most.
Formulas

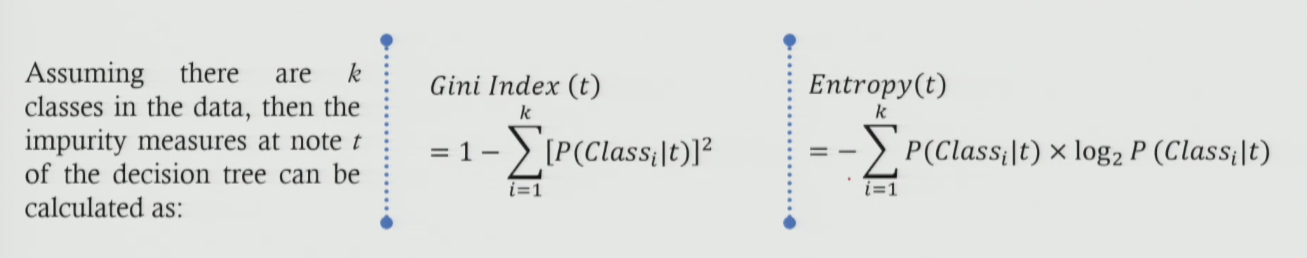

Section titled “Formulas”- Gini Index Formula:
Gini(t) = 1 − Σᵢ [ P(class i | node t) ]²- For binary (k=2):
Gini(t) = 1 − (p₁² + p₂²) - Range: 0 (perfectly pure) to 0.5 (50-50 split - maximum impurity)
- For binary (k=2):
- Entropy Formula:
Entropy(t) = − Σᵢ P(class i | node t) × log₂[ P(class i | node t) ]- Range: 0 (perfectly pure) to 1 (50-50 split - maximum impurity)
Gini and Entropy values for key scenarios
Section titled “Gini and Entropy values for key scenarios”| Scenario | Class 1 (%) | Class 2 (%) | Gini Index 1 − Σp² | Entropy -Σp·log₂(p) | Impurity Level |
|---|---|---|---|---|---|
| All in Class 1 | 100% | 0% | 1 − (1² + 0²) = 0 | −(1·log₂1 + 0·log₂0) = 0 | Zero ✓ (Pure) |
| All in Class 2 | 0% | 100% | 1 − (0² + 1²) = 0 | −(0·log₂0 + 1·log₂1) = 0 | Zero ✓ (Pure) |
| 50-50 Split | 50% | 50% | 1 − (0.5² + 0.5²) = 0.5 | −(0.5·log₂0.5 + 0.5·log₂0.5) = 1 | Maximum ✗ |
| Node 0 (Root) | 64% | 36% | 1 − (0.64² + 0.36²) = 0.46 | - | High (near max) |
Key Insight from Impurity Graph

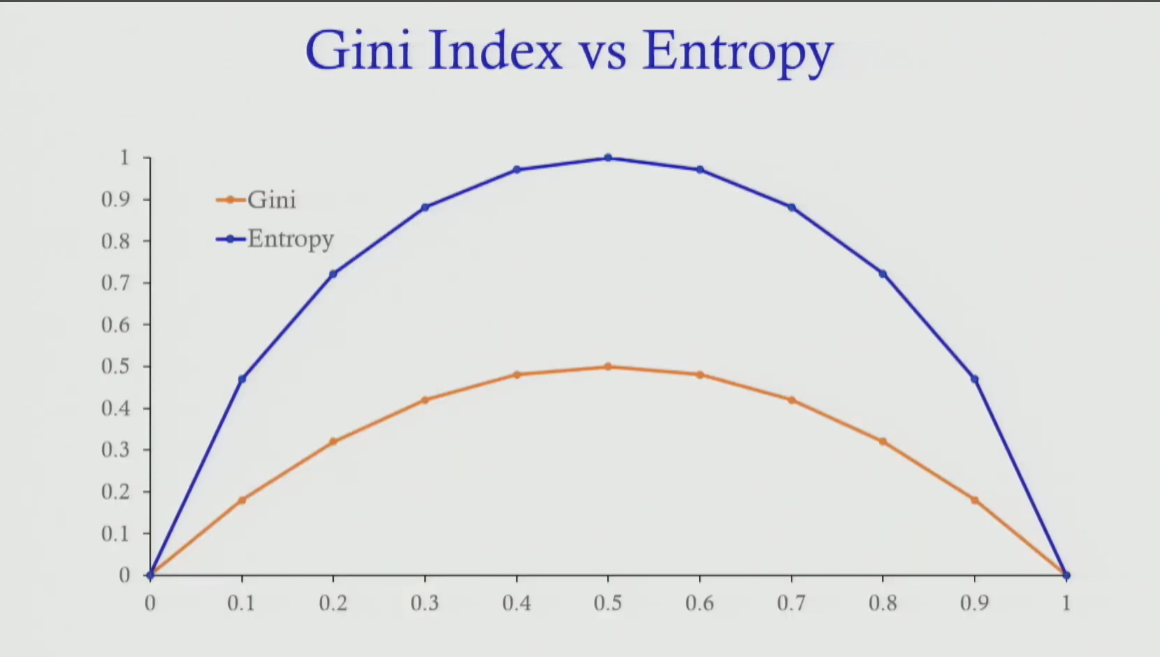

Section titled “Key Insight from Impurity Graph”- Shape: Inverted U - symmetric around 0.5
- Both Gini and Entropy start at 0 (all in one class) → rise to maximum at 0.5 (50-50 split) → fall back to 0 (all in other class)
- Implication: When splitting a node, we want to move observations AWAY from 0.5 towards either end (0 or 1) → reduce impurity → improve accuracy
Splitting Logic - How to Choose Variable and Cutoff
Section titled “Splitting Logic - How to Choose Variable and Cutoff”ΔImpurity = Gini(parent) − [ wL × Gini(left) + wR × Gini(right) ]At each node, try ALL variables (age, utilisation, MTBF, oil, etc.) with ALL possible cutoff values. For each (variable, cutoff) pair, calculate weighted reduction in impurity.
- Reduction in Impurity Formula:
ΔImpurity = Gini(parent node) − [ w_left × Gini(left child) + w_right × Gini(right child) ]wherew_left = (obs in left child) / (obs in parent)andw_right = (obs in right child) / (obs in parent) - Choose: The (variable, cutoff) pair that gives the LARGEST ΔImpurity → this is the best split
Node-by-Node Splitting Trace - Full Tree
Section titled “Node-by-Node Splitting Trace - Full Tree”All nodes - observations, Gini, splitting variable, cutoff, impurity reduction
Section titled “All nodes - observations, Gini, splitting variable, cutoff, impurity reduction”| Node | Obs. Count | Yes% / No% | Gini | Split Variable | Cut-off | Reduction in Impurity | Child Nodes |
|---|---|---|---|---|---|---|---|

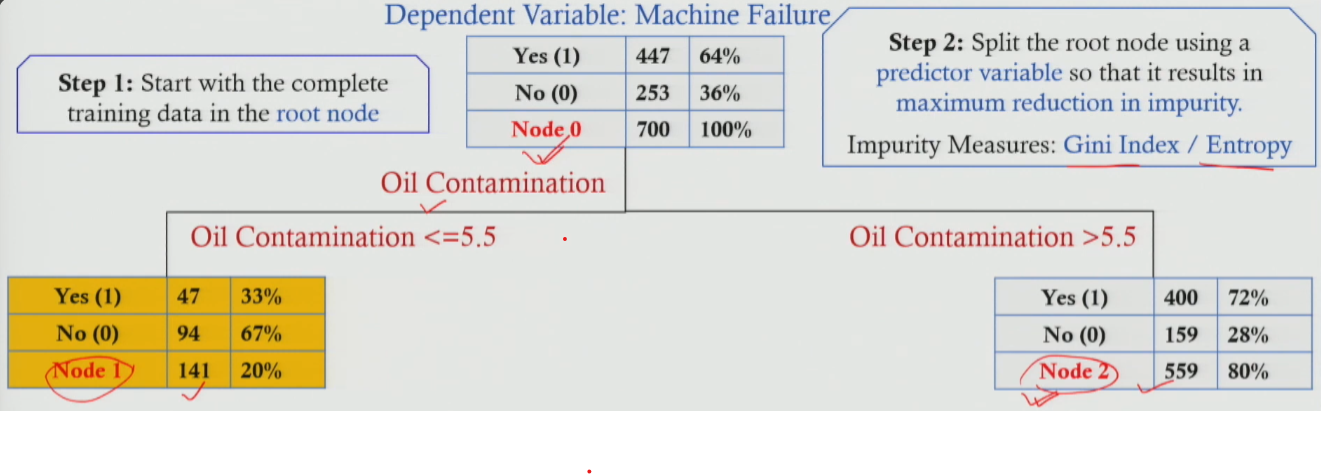

| 0 (Root) | 700 total (447 Yes, 253 No) | 64% / 36% | 0.46 | Oil Contamination | 5.5 | 0.052 (Maximum) | → Node 1, Node 2 |
| 1 | 141 total | Oil ≤ 5.5 | 0.44 | Utilisation | 92.05% | 0.38 (Max at Node 1) | → Node 3, Node 4 |
| 2 | 559 total (72% Yes) | Oil > 5.5 | 0.40 | MTBF | 23.95 | 0.11 (Max at Node 2) | → Node 5, Node 6 |

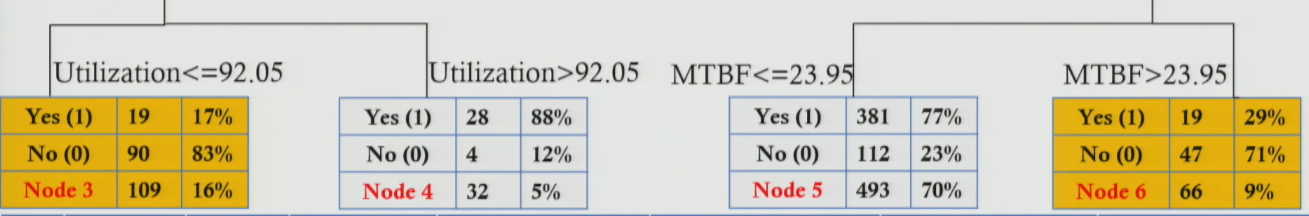

| 3 (Leaf) | 109 obs. | 17% / 83% | 0.28 | STOP | - | - | Predict: NOT FAIL |
| 4 (Leaf) | ~35 obs. | 88% / 12% | 0.21 | STOP | - | - | Predict: FAIL |
| 5 (Leaf) | 493 obs. | 77% / 23% | 0.35 | STOP | - | - | Predict: FAIL |
| 6 (Leaf) | 66 obs. | 29% / 71% | 0.41 | STOP | - | - | Predict: NOT FAIL |
Accuracy Progression - How Each Split Improves Prediction
Section titled “Accuracy Progression - How Each Split Improves Prediction”| Stage | Information Available | Best Prediction Accuracy | Interpretation |
|---|---|---|---|
| Node 0 (No info) | None - just know the machine exists | 64% (baseline) | 64% chance it will fail based solely on history. |
| After Split 1 (Node 2) | Oil Contamination > 5.5 | 72% (+8%) | Knowing oil is high contamination improves accuracy. |
| After Split 2 (Node 5) | Oil > 5.5 AND MTBF ≤ 23.95 | 77% (+5%) | Adding MTBF info pushes accuracy further to 77%. |
| Node 4 (Best leaf) | Oil ≤ 5.5 AND Utilisation > 92.05% | 88% (+24%) | Highest accuracy leaf - overutilised machines very likely to fail. |
Key takeaway: Each split adds information → accuracy increases. Each additional split adds less accuracy improvement than the previous one (diminishing returns) → reason to stop.
Stopping Criteria & Overfitting
Section titled “Stopping Criteria & Overfitting”Why Stopping is Critical - Overfitting: If no stopping: Tree keeps splitting → eventually each leaf has just 1 observation → 100% accuracy on training data.
- Problem: Model “memorised” training data instead of learning patterns → poor accuracy on new test data (Overfitting).
- Fix: Apply stopping criteria to produce a simpler, more general model.
Three stopping criteria used in classification trees
Section titled “Three stopping criteria used in classification trees”| Stopping Criterion | Definition | How Used in This Example |
|---|---|---|
| Max Tree Depth | Stop splitting once the tree reaches a pre-set maximum depth. | Depth = 2 used. No further splitting beyond that. |
| Min. Observations per Node | Do not split a node if it contains fewer than a minimum number (or %) of training observations. | Node 6 has ~9% and Node 4 has ~5%, triggering stop if min=10%. |
| Min. Reduction in Impurity | Do not split if the gain in purity is below a set threshold (epsilon). | Prevents tiny, meaningless splits. |
4-Step Algorithm - How to Build a Classification Tree
Section titled “4-Step Algorithm - How to Build a Classification Tree”- Start at root: Place all training data in the root node (Node 0). Calculate initial Gini (or entropy).
- Find best split: For each node, try all possible (variable, cutoff) combinations. Select the one that gives maximum reduction in impurity (ΔImpurity).
- Repeat: Apply Step 2 to each new internal node created. Keep splitting until a stopping criterion is met.
- Stop and classify: At each leaf node, assign the majority class as the prediction. Report probability = proportion of that class in the leaf, and support = proportion of training data in that leaf.
Session Summary
Section titled “Session Summary”- Root node baseline: 700 obs | 64% failure rate | Gini = 0.46 - high impurity, needs improvement
- Impurity measures: Gini Index = 1 − Σp² | Entropy = −Σp·log₂(p). Both = 0 for pure nodes, maximum at 50-50 split.
- Splitting criterion: Choose (variable, cutoff) with maximum ΔImpurity
- Accuracy progression: 64% (baseline) → 72% (after oil split) → 77%/88% (after 2nd split)
- Stopping criteria: Max depth | Min observations per node | Min ΔImpurity
- Overfitting: No stopping → 100% training accuracy but poor test accuracy. Stopping = essential for generalisation.
- Next session: Python hands-on - implement this exact model in code, reproduce the same output
